Opinion

Supply shortages and an inflexible market give rise to high power transformer lead times

Transformers are a key component in large-scale renewables projects. However, high lead times and rising manufacturing costs are at risk of causing expensive project delays and preventing power plants from being brought online

4 minute read

Sagar Chopra, Senior Research Analyst, Solar, Wood Mackenzie

Sagar Chopra

Senior Research Analyst, Solar

Benjamin Boucher | Senior Analyst, Supply Chain | Wood Mackenzie

Benjamin Boucher

Senior Analyst, Supply Chain

Our recent report, ‘Supply shortage and high lead times: market dynamics and supply chain update’, explores transformer market dynamics and the factors driving supply shortages. Drawing on proprietary data, insights from research analysts, and deep industry links, we look to understand the transformer sector in greater detail, revealing the reasons behind the increase in lead times, and the rise in component costs.

Fill out the form on the top right to download an extract from the full report, or read on for an introduction to the challenges and opportunities across the sector.

Transformer replacement programmes underway at power plants

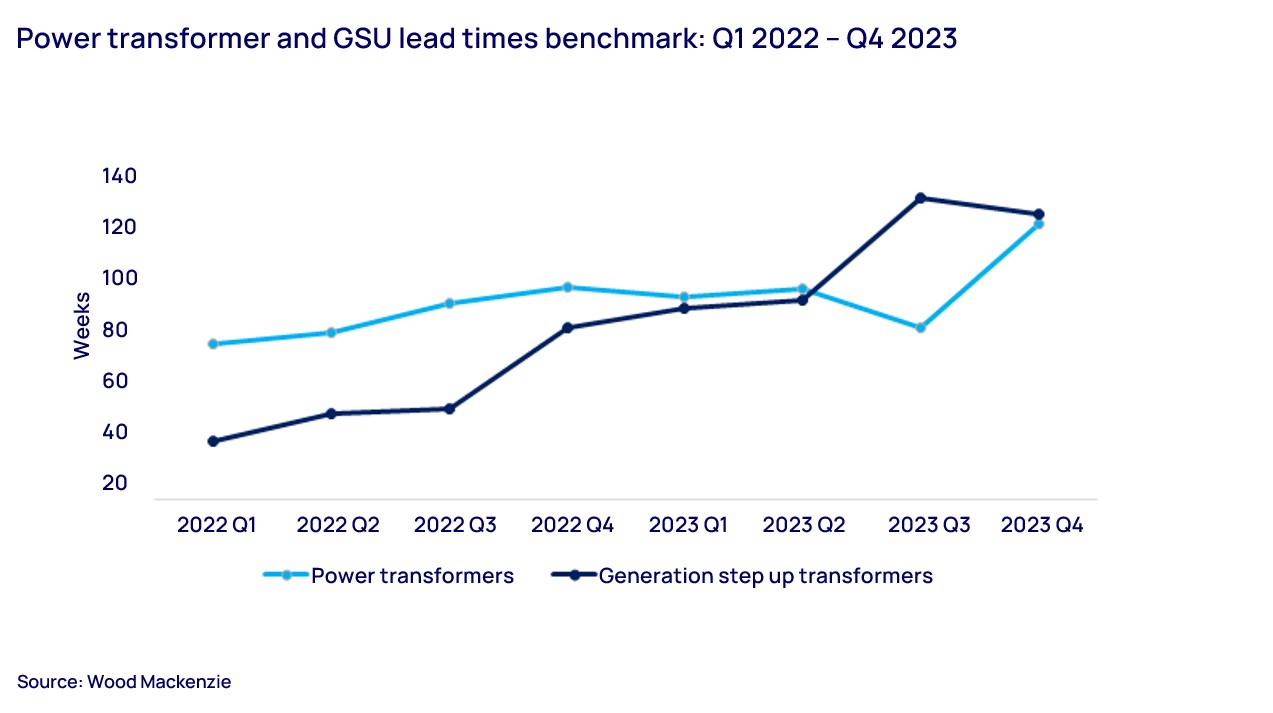

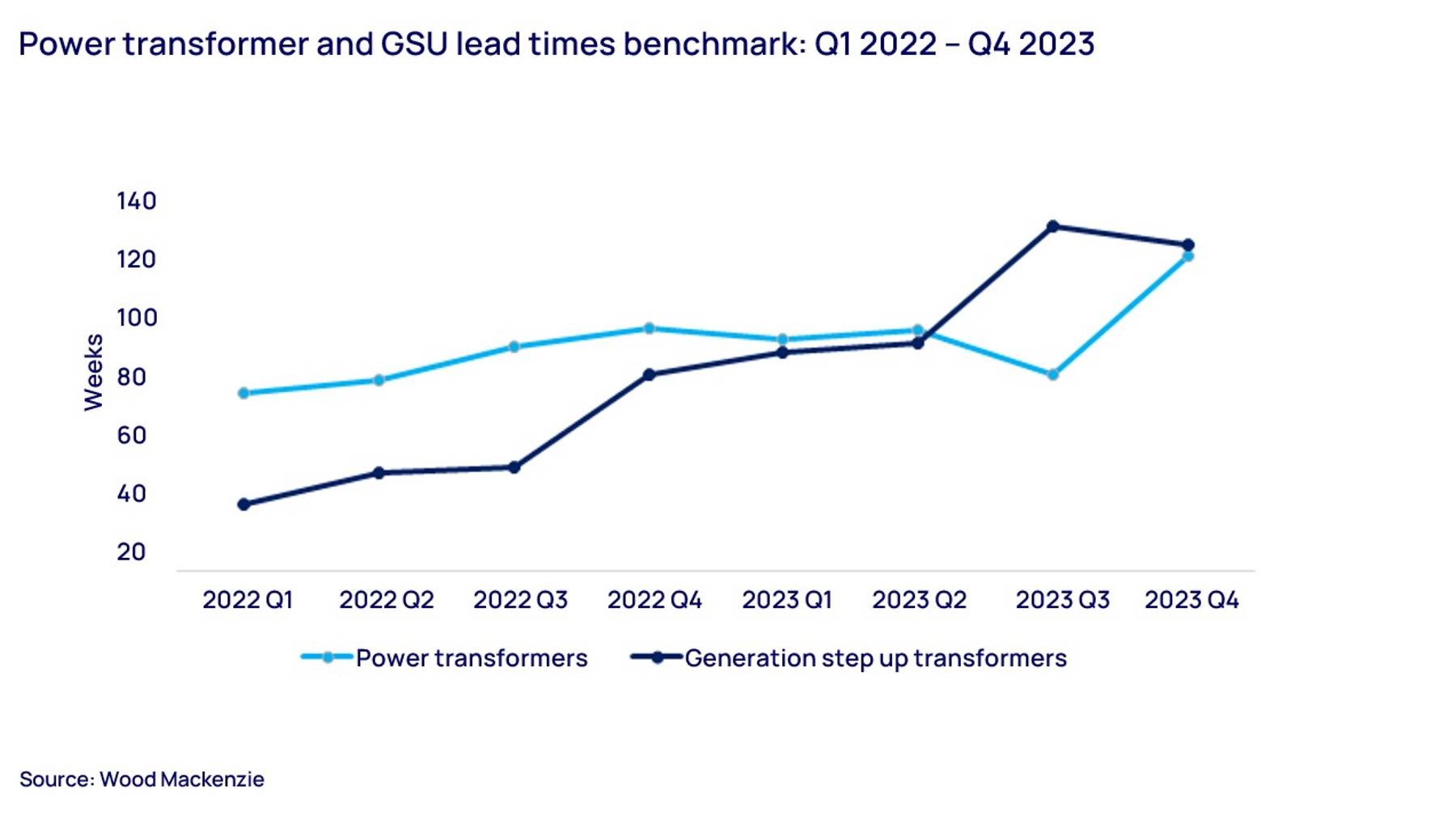

Transformer lead times have been increasing for the last 2 years - from around 50 weeks in 2021, to 120 weeks on average in 2024.

Large transformers, both substation power, and generator step-up (GSU) transformers, have lead times ranging from 80 to 210 weeks, and some manufacturers have already announced plans to expand capacity to meet growing demand.

As the global installed base of power transformers continues to age, active replacements are underway at most utilities. In the US, a multi-decade replacement programme is underway as installed transformers surpass their 35 to 40-year design life.

In addition to the supply chain imbalance brought about by the pandemic, transformer lead times have also increased because components require custom specifications that can only be provided by specialist manufacturers.

Manufacturers risk financial instability

Given that it can take decades for transformer manufacturers to break even, many are reluctant to make the investments required to expand production. The same manufacturers that acquired the technology and financial capital in the 1980s, are enjoying full production slots and higher margins because of increased global demand. In turn, this limits their motivation to expand and risk financial instability.

Likewise, major original equipment manufacturers (OEMs) continue to cite material, equipment, and skilled labor constraints as driving factors for supply constraints and consequent increased lead times.

In the US, only around 20% of transformer demand can be met by domestic supply. Despite President Biden signing executive orders In June 2022 to help domestic manufacturers increase their production, funding has yet to be specified in any subsequent bills.

Raw material costs doubled

Transformer prices have risen 60% to 80% on average since January 2020. Commodity prices for raw materials such as Grain Oriented Electrical Steel (GOES) have doubled since January 2020, while copper prices have increased approximately 50% over the same time frame.

During the pandemic, manufacturers expected a drop in demand for transformers, and production for these commodities slowed down. As a result, manufacturers are now struggling to ramp up production levels to meet global demand.

GOES prices have surged by almost 100% since January 2020, driven by a significant market deficit and key manufacturers curtailing production. Prices have eased slightly since peaking in Q4 2023, but the market is expected to remain volatile moving forward amid capacity constraints and growing demand. This has resulted in GSU transformers seeing a 4% to 15% increase in exposure to GOES over the same period.

Despite the raw material costs easing over the past 12 months, transformer costs have continued to increase as suppliers elevate margins to maintain higher costs due to the strong demand and long lead times.

Potential delays to global renewables projects

As utility companies and project developers face transformer shortages, manufacturing players like Virginia Transformer Corporation and WEG have opened new manufacturing plants to increase their production capacity. Likewise, Sunbelt Solomon has made an investment to establish facilities that support the repair and recycling of transformers.

However, based on conversations with developers and suppliers, we predict that as much as 25% of global renewable projects could be at risk of project delays due to high transformer lead times.

The global demand for standalone photovoltaic (PV), wind and grid scale storage are all expected to grow, which will continue to put pressure on lead times. Unless adequate project planning is put in place to account for supply shortages, many projects could end up being delayed.
